Industry: Transportation Product: Tamara Application: Fleet maintenance optimization
A global logistics operator launched a fleet-wide mid-life overhaul programme — 5,000 vehicles cycled through depots in waves: condition assessment, teardown, parts, rebuild, recommissioning, hand-back. Scheduled the orthodox way, with most-likely durations rolled through the network, it showed a 670-day, May 2028 finish. Every vehicle off the road bleeds revenue, so the date mattered. It was also the answer to a question no fleet manager should ask — what if every long-lead part arrives on its most-likely date and every depot wave runs clean?
Rebuilt in Tamara, Vose Software's Monte Carlo project risk tool, with each stage carrying a Beta-PERT duration and six discrete risks layered on, the date dissolves into a distribution: P50 November 2028, P90 March 2029, and a probability of finishing by the published May 2028 plan of just 1%. The S-curve puts the deterministic plan at the very foot of the curve.
The gap between the May 2028 plan and the P80 finish is 279 days — roughly 9.2 months. That gap is the programme's true contingency, and it lives in the parts pipeline.
A deterministic roll-up adds most-likely durations along one assumed chain. Durations are right-skewed — a stage can finish a little early but overrun a lot — so the mean simulated finish is 868 days against the 670-day plan. And with two depot waves drawing on a shared parts pool, whichever wave waits longest for parts in a given iteration drives the merge into recommissioning.
Tamara ranks each stage by cruciality — the rank-correlation between its duration and the programme finish.
Long-lead parts procurement dominates (cruciality 0.64), well ahead of the engine & drivetrain rebuild (0.51) and wave-A teardown (0.29). The message is unambiguous: this is a supply-chain programme wearing a maintenance schedule. Buying certainty on parts lead-time — dual-sourcing, framework contracts, forward ordering — moves the finish more than any improvement to depot throughput.

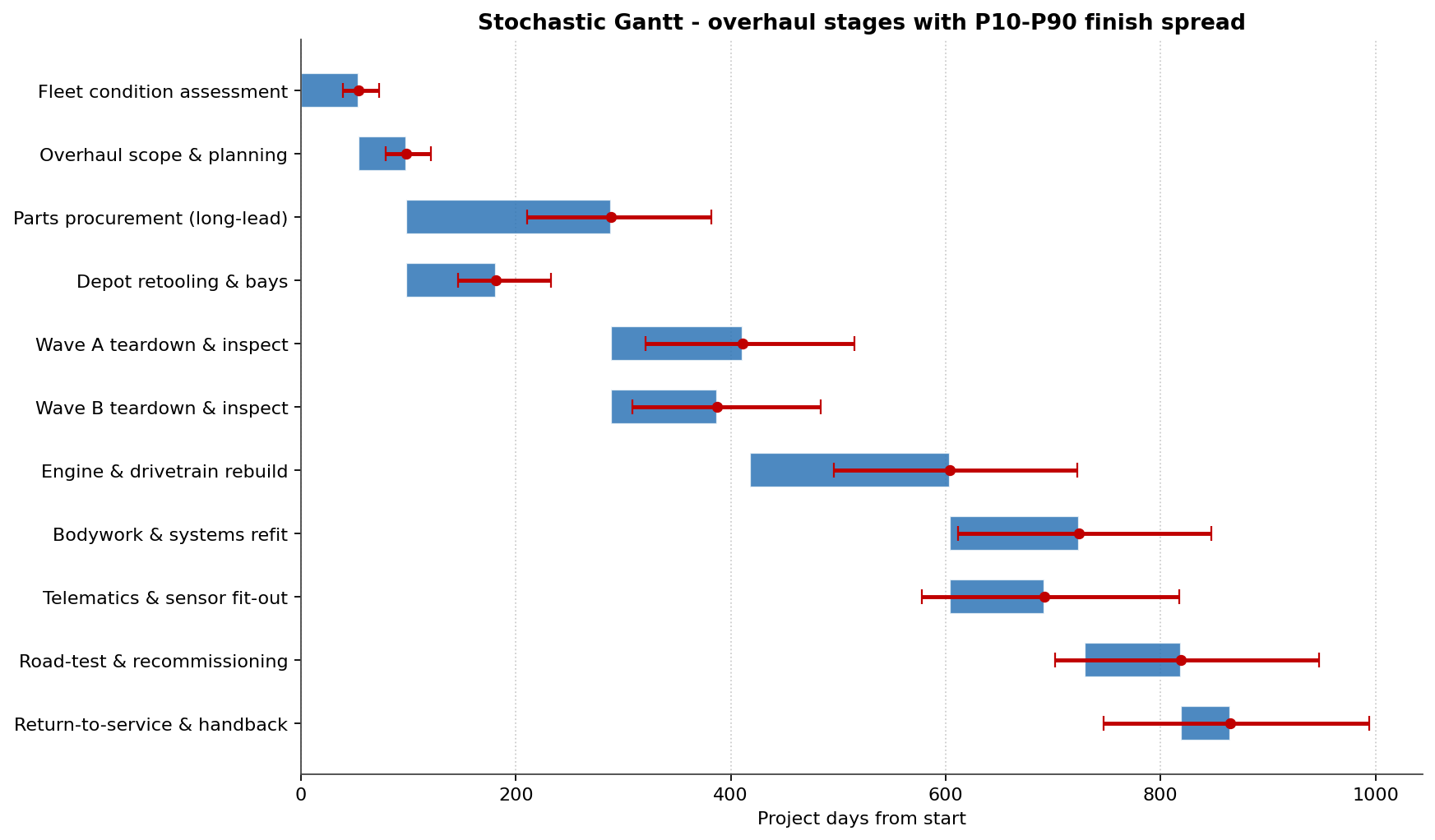

The same simulation places every stage in time as a band, not a bar:
The whiskers widen downstream because uncertainty compounds: recommissioning inherits the spread of teardown, rebuild and refit, so hand-back carries the accumulated variability of the whole programme.

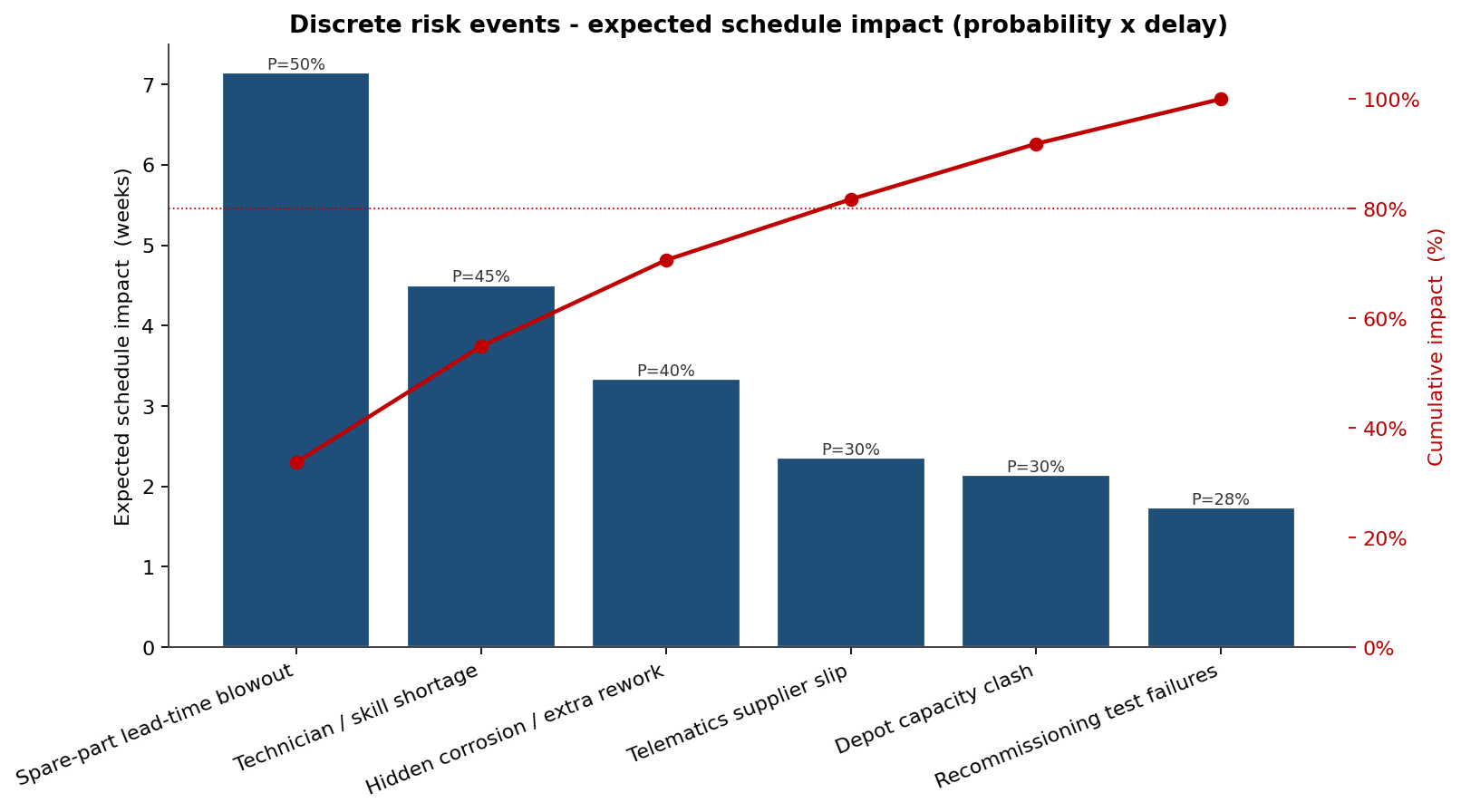

Six discrete events were modelled as Bernoulli risks. Ranking them by expected schedule impact (probability × delay) gives a clean Pareto:
Four of the six events carry ~80% of the expected discrete-event delay — a spare-part lead-time blowout (7.1 weeks expected), a technician/skill shortage (4.5), hidden corrosion driving extra rework (3.3) and a telematics supplier slip (2.4). The single largest, by a wide margin, strikes the parts pipeline — echoing the tornado.

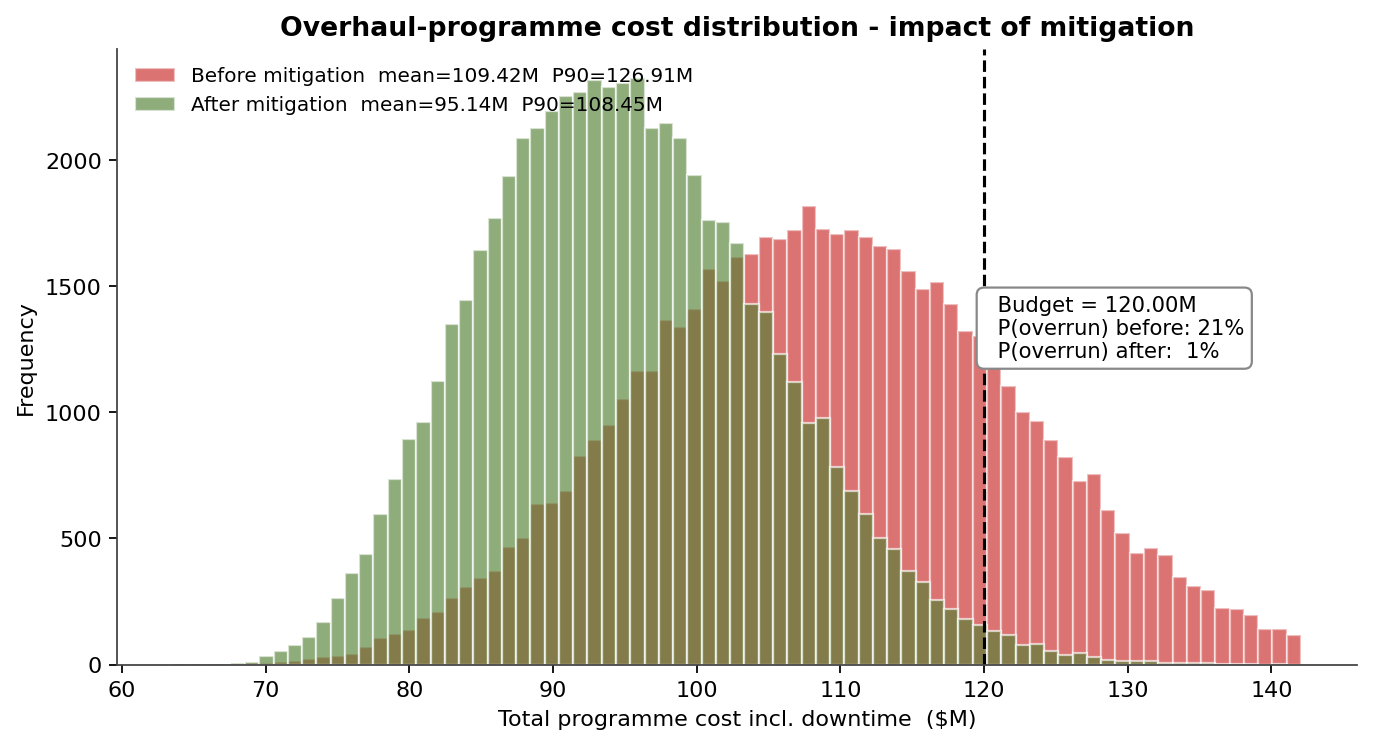

Every day the programme runs long keeps vehicles off the road, so downtime cost rides directly on the schedule distribution. Tamara let the team price a mitigation package together — predictive-maintenance triage, a dual-sourced parts framework and a technician training/agency surge — and compare before/after on one axis:
Without mitigation the programme cost, including downtime, runs to a mean of $109M and a P90 of $127M, with a 21% probability of breaching the $120M budget. The mitigation package cuts the P80 finish by 131 days (949 → 818 days), and because downtime drives cost, the overrun probability falls from 21% to 1% — the package pays for itself many times over in avoided fleet downtime.
A fleet overhaul is not a date; it is a distribution governed by the part you are waiting on. Tamara is what turns "when is the fleet back?" into a probability operations and finance can both sign.
