Industry: Energy Product: Tamara Application: Renewable energy project risks
A 200 MW onshore wind farm was developed against a fixed grid-connection and power-purchase deadline. The deterministic plan — an eleven-activity most-likely roll-up — put grid connection at day 930. Missing that window did not merely delay revenue; it risked forfeiting the contracted price and triggering liquidated damages, while financing carry accrued throughout. For a project competing on slim margins, the connection date was the business case — and the first thing the developer needed was an honest probability of hitting it.
Rebuilt in Tamara, Vose Software's Monte Carlo project risk tool, with Beta-PERT durations on every activity and six discrete risk events layered on top, the deterministic date dissolves into a distribution: a P50 of day 1109 and a P90 of day 1240, and a probability of connecting by the published day-930 plan of just 2%. The S-curve below is the whole argument — the deterministic plan sits at the very foot of the curve, in the regime a developer commits to only at the cost of the price it was counting on.
The gap between the day-930 plan and the P80 connection is 264 days — about 8.7 months of exposure to lost price and liquidated damages that the deterministic roll-up never quantified.
A bar-chart critical path adds most-likely durations along one assumed-longest chain. Two things break it. First, durations are right-skewed — an activity can finish a little early but can overrun a lot, so the mean simulated connection is 1,113 days against the 930-day plan. Second, with parallel chains (permitting, grid-connection agreement, turbine supply and civil works all branch from the early phases), whichever chain happens to be longest in a given iteration drives the finish, so the project inherits the worst of several paths, not the average of one.
Tamara reports each activity's cruciality — the rank-correlation between its duration and the connection date, i.e. how much its variability actually moves the date.
Permitting and environmental dominates (cruciality 0.63), followed by turbine delivery and erection (0.45) and the turbine supply contract and order (0.32). The action list is clear: permitting certainty and the turbine supply chain together account for most of the connection-date variability, and the two highest-leverage weeks of risk reduction belong there — not on whichever task the team finds easiest to compress.

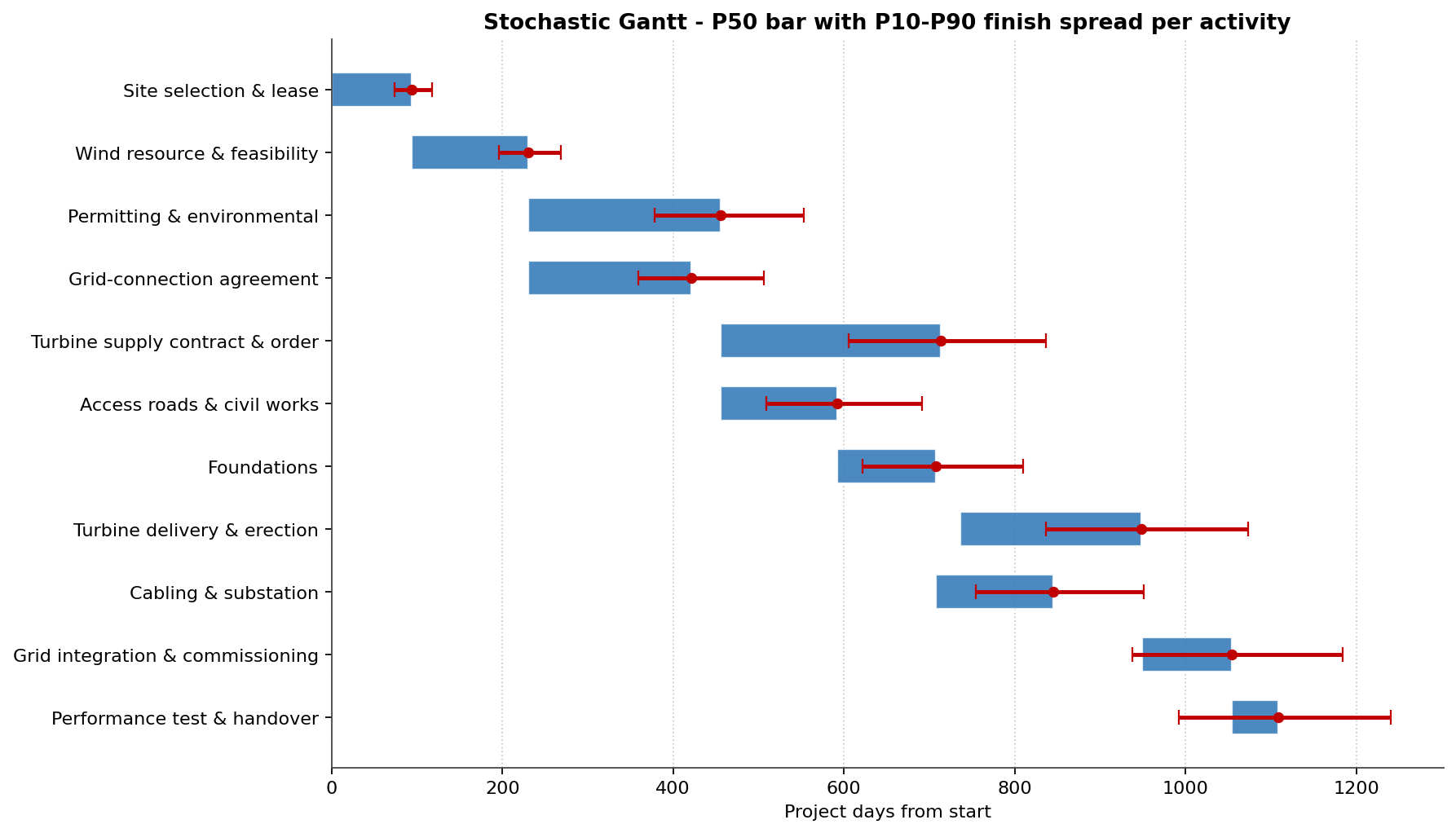

The same simulation places every activity in time as a band, not a bar:
The whiskers widen downstream because uncertainty compounds along the chain: the turbine supply, delivery and erection bars carry the widest whiskers, and because they sit in series the spread compounds toward the connection date.

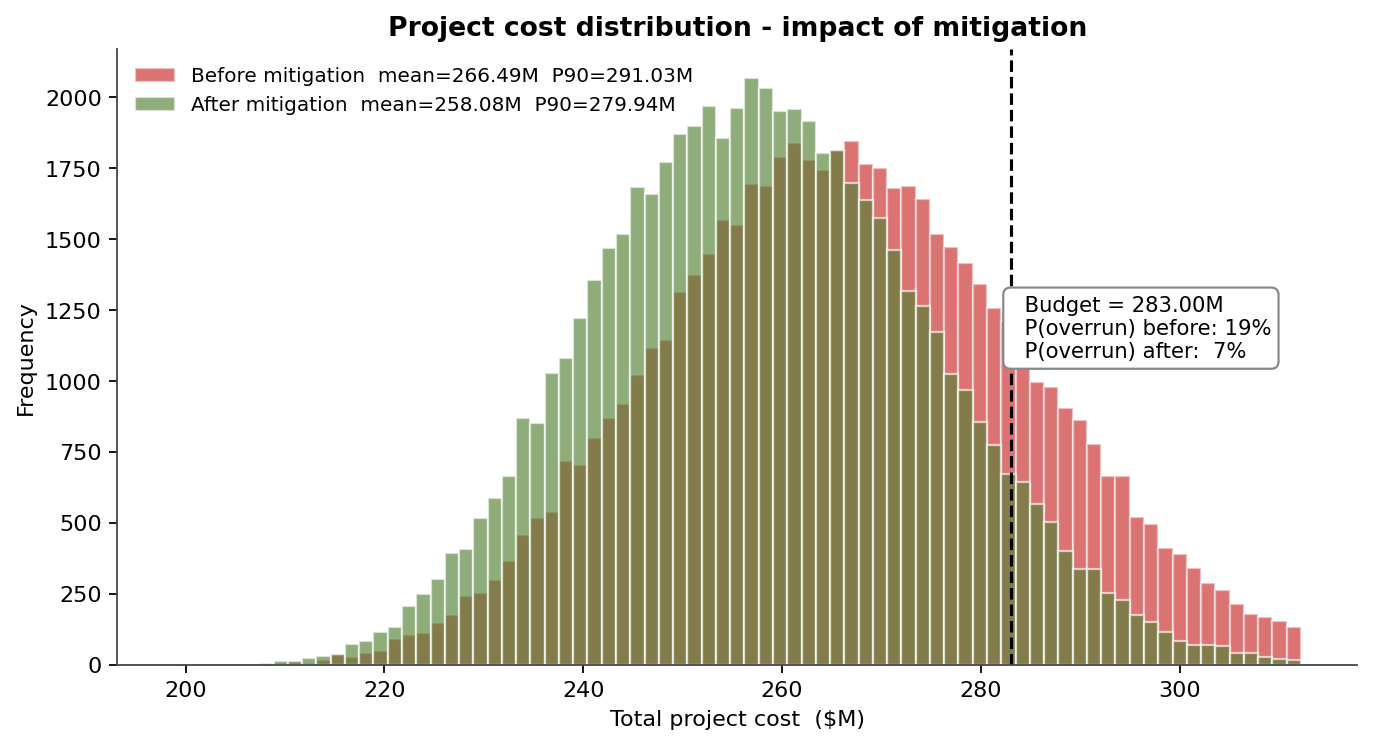

Every day beyond the deterministic plan carries financing carry plus the liquidated-damages and lost-price exposure of missing the connection window, so the schedule distribution drives the cost distribution. Tamara let the team price a mitigation package — an early turbine reservation, enhanced permitting and stakeholder engagement, and a weather buffer with a secured crane slot — and compare before/after on the same axis:
Without mitigation the all-in cost runs to a mean of $266M and a P90 of $291M, with a 19% probability of breaching the $283M budget. The mitigation package cuts the P80 connection by 85 days (1,194 → 1,109 days), and because schedule drives cost, the overrun probability falls from 19% to 7% — value that lands largely in avoided carry and damages rather than in the activities the package touches directly.
The six discrete events were modelled as Bernoulli risks. Ranking them by expected schedule impact (probability × delay) gives a clean Pareto:
Four of the six events carry ~80% of the expected discrete-event delay — a permitting/community objection (6.2 weeks expected), a turbine supply-chain delay (5.1), severe-weather lost days (3.9) and a grid-connection re-study (3.7). Once the ranking is visible, the risk-response budget writes itself.
A renewable project lives or dies on its connection date, and a connection date is a distribution. Tamara is what turns "will we make the window?" into a probability the developer, the lender and the offtaker can all sign.
