Industry: Agriculture and Food Supply Chain Product: ModelRisk Application: Optimizing Food Supply Chain Operations Under Uncertainty
A global agribusiness runs eleven critical supply-chain nodes — grain origination, ports, shipping lanes, processing clusters and distribution hubs — spread across four regions. Each carries an annual disruption probability and a severity if it fires. Add them up as independent risks and the 95th-percentile annual disruption cost is about $49M; that is the contingency reserve the planning spreadsheet implicitly sizes. Model the same eleven nodes with the correlation that actually governs them — nodes in the same region share a climate, political and logistics shock, so they tend to fail together — and the P95 jumps to $61.5M, with the P99 rising from $87.6M to $106.9M. The independence assumption does not make the company a little optimistic; it under-reserves the 1-in-20 year by $12.6M and the 1-in-100 year by $19.4M.
The reason is structural, not a tuning artefact. What exhausts a disruption budget is never the average year — it is the year a whole region goes down at once: a drought that hits every origination point in South America, or a chokepoint event that closes both the sourcing and the transit node in the same corridor. A model that treats those nodes as independent literally cannot generate that year often enough, so it prices a tail that does not exist.

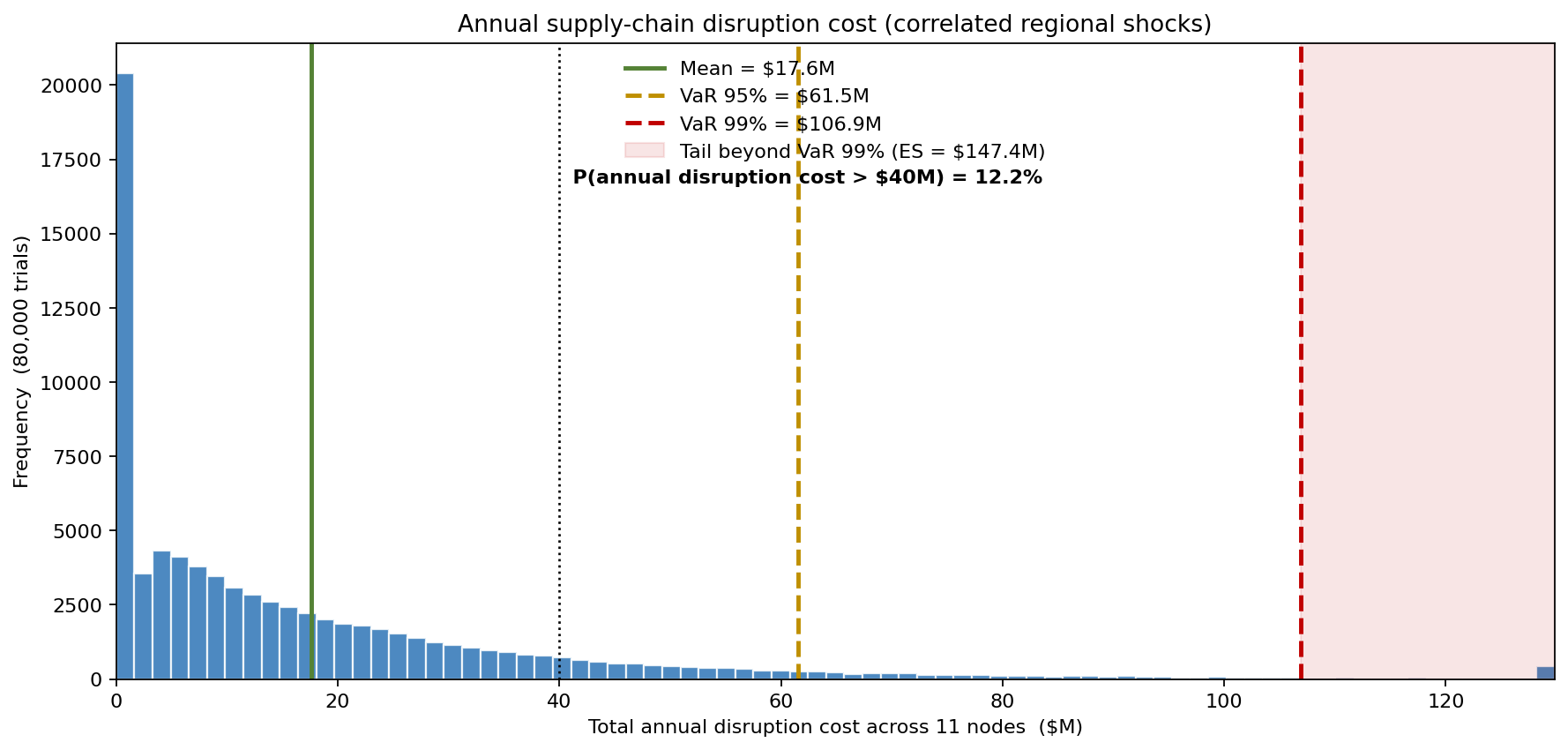

The headline is the distribution of total annual disruption cost across all eleven nodes, with regional shocks correlated:
The mean annual cost is $17.6M, but the distribution is severely right-skewed: the P95 (Value-at-Risk) is $61.5M, the P99 is $106.9M, and the expected shortfall beyond the P99 — the average of the worst 1% of years — is $147.4M. There is a 12.2% probability the annual disruption bill exceeds $40M. A contingency set to the mean is overwhelmed roughly one year in eight; the number that matters for solvency is the tail, and the tail is an order of magnitude above the average.
A single expected-cost figure throws away the two things that decide whether a contingency budget survives a bad year. First, the aggregation: disruption cost is a sum of frequency times severity across eleven nodes, and the sum has a much wider distribution than any single node. Second — and decisively — the correlation: regional nodes share a driver, so their disruptions are not independent draws. An expected value is identical whether the nodes are independent or perfectly coupled; only the distribution's tail tells them apart, and the tail is exactly what a reserve must cover.
The model places each node's disruption on a one-factor structure: a shared regional factor plus node-specific noise, so within-region nodes fail together while regions remain largely independent. The same regional factor also inflates severity, because a region-wide event drives shared scarcity and surge freight. Comparing the resulting cost distribution against the independence assumption makes the effect unmistakable:
The two curves share almost the same body — the means are close, $17.6M correlated against $15.5M independent — but they diverge in the tail, where the P99 is $106.9M correlated against $87.6M independent, a $19.4M (×1.22) understatement. The correlation is genuinely present in the simulation, not just asserted: the empirical pairwise correlation of disruption events is 0.24 within a region and 0.00 across regions, exactly the structure the one-factor copula imposes. Assume independence and you price the wrong tail.

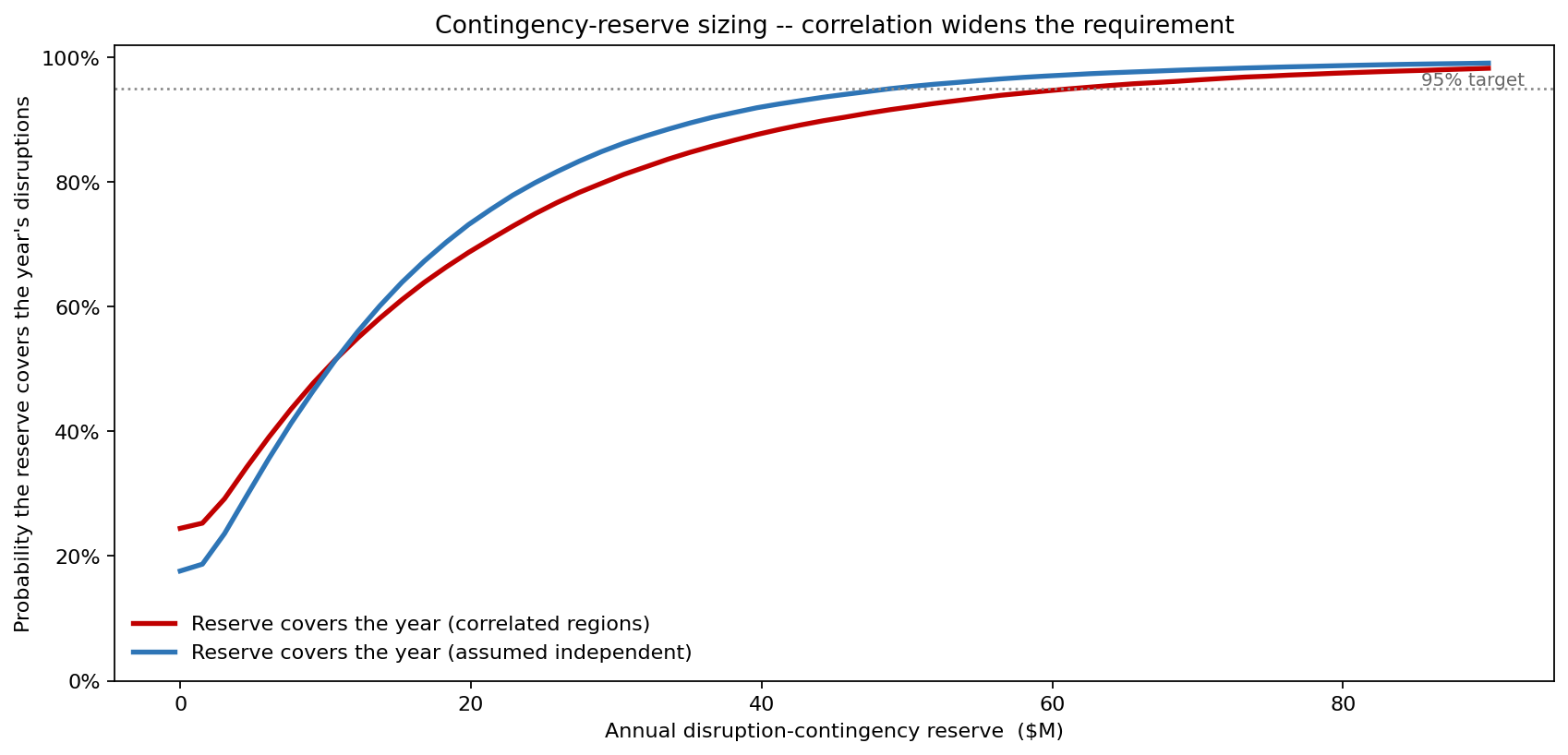

The reserve question is "how much do we need to set aside to cover the year with a given confidence?" — and the answer depends on whether you respect the correlation:
To cover the year with 95% confidence requires $61.5M under the correlated model but only $48.9M if you assume independence — a $12.6M gap. At 99% confidence the requirement is $106.9M correlated against $87.6M independent, a $19.4M gap. The correlated curve sits consistently to the right: every confidence level demands a larger reserve once you admit that regions fail together. The independence assumption is not conservative — it is the cheaper, wrong answer.
Removing each region's disruptions in turn and measuring the drop in the P95 cost ($61.5M) ranks the regions by tail contribution. East Africa / Red Sea is the largest single driver (a $14.0M reduction in the P95 if its disruptions were eliminated), followed by SE Asia (-$11.8M) and South America (-$10.4M), with North America / Europe the smallest (-$7.0M). This is where correlation pays off as insight: the regions that own the tail are the ones whose nodes move together, so dual-sourcing and chokepoint diversification there buy more tail reduction per dollar than the same spend spread evenly.
A supply-chain risk budget built on summed independent risks is a bet that no region ever fails as a whole. Monte Carlo simulation in ModelRisk replaces that bet with a correlated distribution — turning "we expect about $17.6M of disruption a year" into "the 1-in-20 year costs $61.5M and the 1-in-100 year costs $107M, and the independence assumption was hiding $19M of that tail."
